Current release¶
What’s new or changed in 9A Advanced Manufacturing for F&SCM 3.2025.07.01
Release version: 3.2025.07.01
Release date: 11/07/2025
Total # work items: 10
Features¶
This section contains a table that lists the features that are included in this release when available. We might update this article to include features that were added to the build after this article was originally published.
ID | App | Title |
---|---|---|
19746 | Advanced Projects | Prevent the cleanup task “Cost calculation details” from removing split cost information |
19861 | Advanced Projects | Override project dimension creation type on project level |
19945 | Advanced Projects | Check sub-project phase when creating estimates from the consolidated view |
19959 | Discrete Manufacturing | Material availability calculation support for transfer orders |
19907 | Discrete Manufacturing | Returnable packaging balances for customers / vendors |
19939 | Windchill - D365 SCM Connector | Create or update product attributes in D365 |
Bugs & Fixes¶
This section contains a table that lists the bugs and fixes that are included in this release when available. We might update this article to include features that were added to the build after this article was originally published.
ID | App | Title |
---|---|---|
19963 | Advanced Projects | Costing sheet snapshot periodic functions are unavailable when not in Admin-mode |

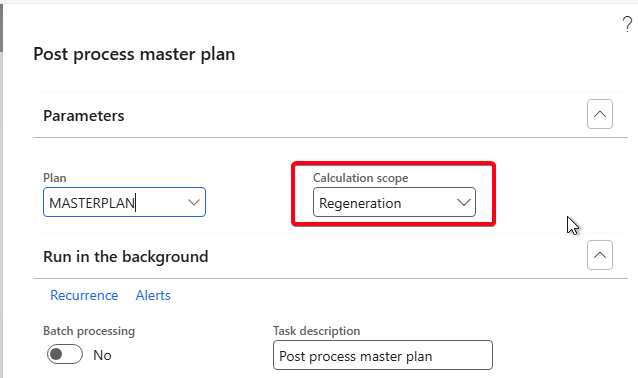

19966 | Advanced Projects | Project logistics pages trigger the legacy master planning even if planning optimization is activated |
19976 | Advanced Projects | Costing sheet can show duplicate project item consumption for project item journals |
20004 | Discrete Manufacturing | Cockpit machine planning - Sorting/filtering on column headers not working (Fixed 3.2025.07.03) |
Detailed notes¶
This section contains the workitems mentioned in the above sections, with additional details and applicable notes
19746¶
- Title: Prevent the cleanup task “Cost calculation details” from removing split cost information
- App: Advanced Projects
- Type: User Story
- Notes: Prevent the cleanup task “Cost calculation details” from removing split cost information.
19861¶
- Title: Override project dimension creation type on project level
- App: Advanced Projects
- Type: User Story
- Notes: When creating project structures, the project parameter Project dimension creation type defines whether the project tracking dimension on sub-projects gets the same dimension as the main project, or a specific sub-project dimension.Some scenario’s however require a mix of the two possibilities, e.g. an initial project and sub-projects getting all the same project dimension, but the service subprojects getting their own sub-project dimension.
To allow this scenario, an additional field Project dimension creation type has been added to the projects, with 3 possible values:- Blank = use the setting from the project parameters
- Only header projects = all sub-projects get the same dimension as the main project
- All project levels = sub-projects get their own sub-project dimension
19963¶
- Title: Costing sheet snapshot periodic functions are unavailable when not in Admin-mode
- App: Advanced Projects
- Type: Bug
- Notes: Users without admin rights have no access to the costing sheet snapshot periodic functions
19966¶
- Title: Project logistics pages trigger the legacy master planning even if planning optimization is activated
- App: Advanced Projects
- Type: Bug
- Notes: If planning optimization has been activated, the project logistics pages still trigger the legacy master planning, leading to error messages. This has been solved by triggering no planning at all in case planning optimization has been activated, but the project logistics pages will still show the results of the planning executed e.g. from the item requirements page.
19976¶
- Title: Costing sheet can show duplicate project item consumption for project item journals
- App: Advanced Projects
- Type: Bug
- Notes: If multiple projects are included in a project item journal, the consolidated costs for all the lines are shown in the costing sheets of the projects included in the journal
19945¶
- Title: Check sub-project phase when creating estimates from the consolidated view
- App: Advanced Projects
- Type: User Story
- Notes: When creating estimates in the costing sheet from the consolidated view, there will be a blocking warning if one of the projects belonging to the estimate project is in a project stage that does not allow estimation.
Remark: standard Finance & Operations does not check this for sub-projects when creating a new estimate.
19959¶
- Title: Material availability calculation support for transfer orders
- App: Discrete Manufacturing
- Type: User Story
- Notes: When calculating material availability for (planned) production orders, materials transferred from another warehouse will be shown as available if they are on hand at that warehouse. This was the case for planned transfers, and has been added for transfer orders as well.
20004¶
- Title: Cockpit machine planning - Sorting/filtering on column headers not working (Fixed 3.2025.07.03)
- App: Discrete Manufacturing
- Type: Bug
- Notes: Since release 3.2025.1.1, filtering and sorting is not possible anymore on the cockpit machine planning. This has been fixed, although there is still inconsistency between the saved views and the pre-defined filters.
19939¶
- Title: Create or update product attributes in D365
- App: Windchill - D365 SCM Connector
- Type: User Story

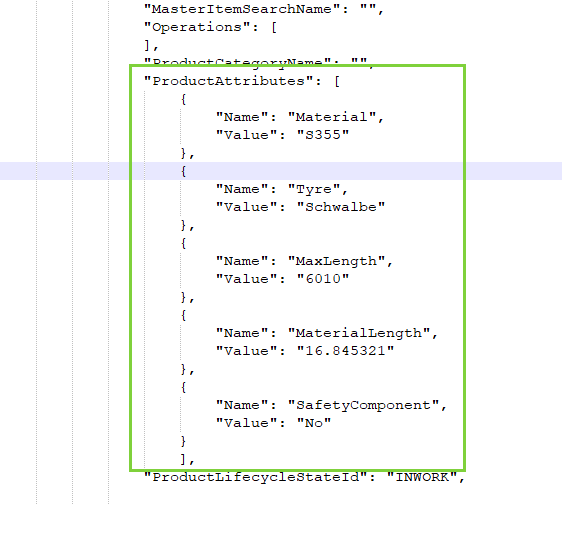

- Notes: Product attributes in D365 SCM (e.g. defined on procurement categories) can be copied from Windchill when creating or updating products.To do so, add a ProductAttributes section to the Parts section in the xsl translation:
